The PJM Interconnection, the massive grid operator managing the flow of electricity across 13 U.S. states and the District of Columbia, stands at a historic crossroads. Faced with an unprecedented surge in electricity demand—driven largely by the explosive growth of data centers and the transition toward electrification—the grid is struggling to balance aging infrastructure with the need for rapid, reliable expansion. As the capacity market faces systemic pressures that threaten to stifle investment, PJM has unveiled a roadmap for reform that could fundamentally reshape the American energy landscape.

The Catalyst for Change: A High-Stakes Regulatory Environment

The push for reform gained significant momentum in January, when a powerful coalition of federal and state stakeholders intervened. The Trump administration, joined by a bipartisan group of governors and federal leaders—including Secretary of Energy Chris Wright and Secretary of the Interior Doug Burgum—called upon PJM to take urgent action. Their mandate was clear: temporarily overhaul market rules to bolster grid reliability and mitigate rising costs for families and businesses. The proposed solution involved a massive infusion of more than US$15 billion in new baseload power generation.

PJM’s subsequent decision to initiate a "Reliability Backstop Procurement" signaled an acknowledgement of these pressures. However, the Board was quick to clarify that this mechanism is intended only as a bridge. PJM does not view itself as a long-term "procuring authority," but rather as a facilitator for a more durable, market-driven solution.

Chronology of the Crisis and Response

The urgency behind these developments is not merely political; it is grounded in operational data that paints a precarious picture for the mid-2020s and beyond.

  • January 2025: High-level political intervention forces PJM to address the "Reliability Backstop" to ensure immediate grid stability.
  • October 2025: The US Energy Storage Coalition (ESC) releases a watershed report highlighting an urgent, near-term requirement for capacity, predicting a massive demand spike by 2032.
  • May 6, 2026: PJM publishes its whitepaper, Powering Reliability Through Market Design, outlining three distinct paths for future market architecture.
  • 2027–2030 (Projected): Implementation windows for the proposed reforms, though experts suggest the practical impact will likely extend well into the 2030s.

Supporting Data: The Load Growth Dilemma

At the heart of the current crisis is a radical upward revision in load forecasts. The primary driver is the proliferation of data centers, which require constant, high-density power. According to the ESC study, PJM faces a looming supply-demand gap. If current trends continue, the region’s summer peak is expected to increase by 16GW by 2028, with an additional 30GW required by 2032.

However, this forecast is not without its skeptics. There is growing pushback against massive data center developments due to their environmental and resource footprints. This creates a "stranded cost" risk: if utility companies invest billions in transmission and generation infrastructure to support projected load growth, but that demand fails to materialize, the burden will fall squarely on existing ratepayers.

As industry expert Levitt notes, while the forecasts already account for a significant reduction in requested versus actual projects, the risk remains. "The question is, who is going to pay for those assets?" says Lam, a sentiment echoed by stakeholders concerned that residential customers could be left footing the bill for underutilized grid investments.

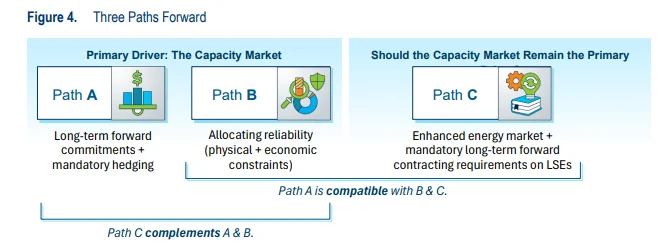

PJM’s Three Paths: Defining the Future

PJM’s whitepaper proposes three distinct philosophical approaches to the role of markets versus central administration.

Path A: Stabilized Markets (The Centralized Model)

Path A leans into long-term hedges and commitments, mirroring the centralized planning models of California or New York. This path shifts power toward state regulators, who would take a more active role in determining the resource mix. Under this model, large-scale load customers like hyperscalers would be required to provide significant financial guarantees—potentially billions in letters of credit—to shield existing customers from the risks of stranded assets.

Path B: Differential Reliability (The Hybrid Approach)

Path B offers a "mix-and-match" strategy. It acknowledges the regional diversity within PJM’s 13-state footprint, allowing different states to pursue different procurement models. This approach attempts to draw clearer lines between the responsibilities of the grid operator and the individual state utility commissions, offering a degree of flexibility that could accommodate varying political and economic priorities.

Path C: Energy Market Transition (The Market-Driven Model)

Path C represents the most "light-touch" approach, relying heavily on market signals similar to the ERCOT model in Texas. By fostering an energy-only market design with precise price signals, it aims to drive efficient investment without heavy-handed regulation. While large load customers would bear more market risk, existing customers could be protected through long-term hedges, effectively keeping spot market prices from overwhelming household budgets.

Implications for Energy Storage

One of the most significant aspects of the current reform effort is the potential role of Battery Energy Storage Systems (BESS). Because batteries provide rapid response and flexibility, they are ideally suited to address the volatility that current market designs struggle to manage.

Levitt highlights that independent of the specific capacity market path chosen, the "Reserve Certainty Senior Task Force" (RCSTF) reforms will be transformative. These reforms are designed to provide better price signals for flexibility, which will inherently favor storage solutions. Last summer served as a precursor: as prices spiked to over US$1,000/MWh during peak demand hours, it became clear that the grid is crying out for the kind of immediate, flexible supply that only BESS can provide.

"The capacity market is not meeting the present moment," Levitt states. "It’s going to fail to procure enough capacity to meet the reliability needs." Consequently, the energy market reforms may eventually prove far more consequential than the capacity market changes, creating a lucrative environment for storage developers.

Official Responses and Strategic Outlook

PJM’s official stance is one of pragmatic urgency. In the conclusion of their whitepaper, they stress that the "supply-demand gap is substantial," and that the time to act is measured in years, not decades. While they have not committed to a final decision date, they emphasize that the status quo is unsustainable.

The core challenge remains: how to balance the need for new infrastructure to support the digital economy with the protection of existing ratepayers. Lam points out that if new capacity is added efficiently, it can actually lower rates by spreading fixed costs across a larger consumer base. However, if the infrastructure is poorly planned or redundant, the cost of the transition could be substantial.

Ultimately, the shift from a traditional, capacity-focused market to one that prioritizes energy-market flexibility marks a paradigm shift. For PJM, the goal is to create a framework that is "durable"—one that can withstand the political, economic, and technological volatility of the next two decades. As the region moves toward 2030, the success of these reforms will depend on the accuracy of load forecasting, the equitable allocation of costs, and the grid operator’s ability to integrate cutting-edge storage technology into a legacy system.

For now, the stakeholders involved—from federal agencies to regional regulators—are watching closely. The decisions made in the coming months will determine whether PJM continues to serve as a reliable engine for the American economy or whether it will be forced to undergo a more painful, reactive transition as the demand for power continues to outpace the current supply-side reality.
